GB/T 24915-2020: Guidance on energy performance contracting
Delivery: 9 seconds. Download (& Email) true-PDF + Invoice.
Get Quotation: Click GB/T 24915-2020 (Self-service in 1-minute)
Historical versions (Master-website): GB/T 24915-2020
Preview True-PDF (Reload/Scroll-down if blank)

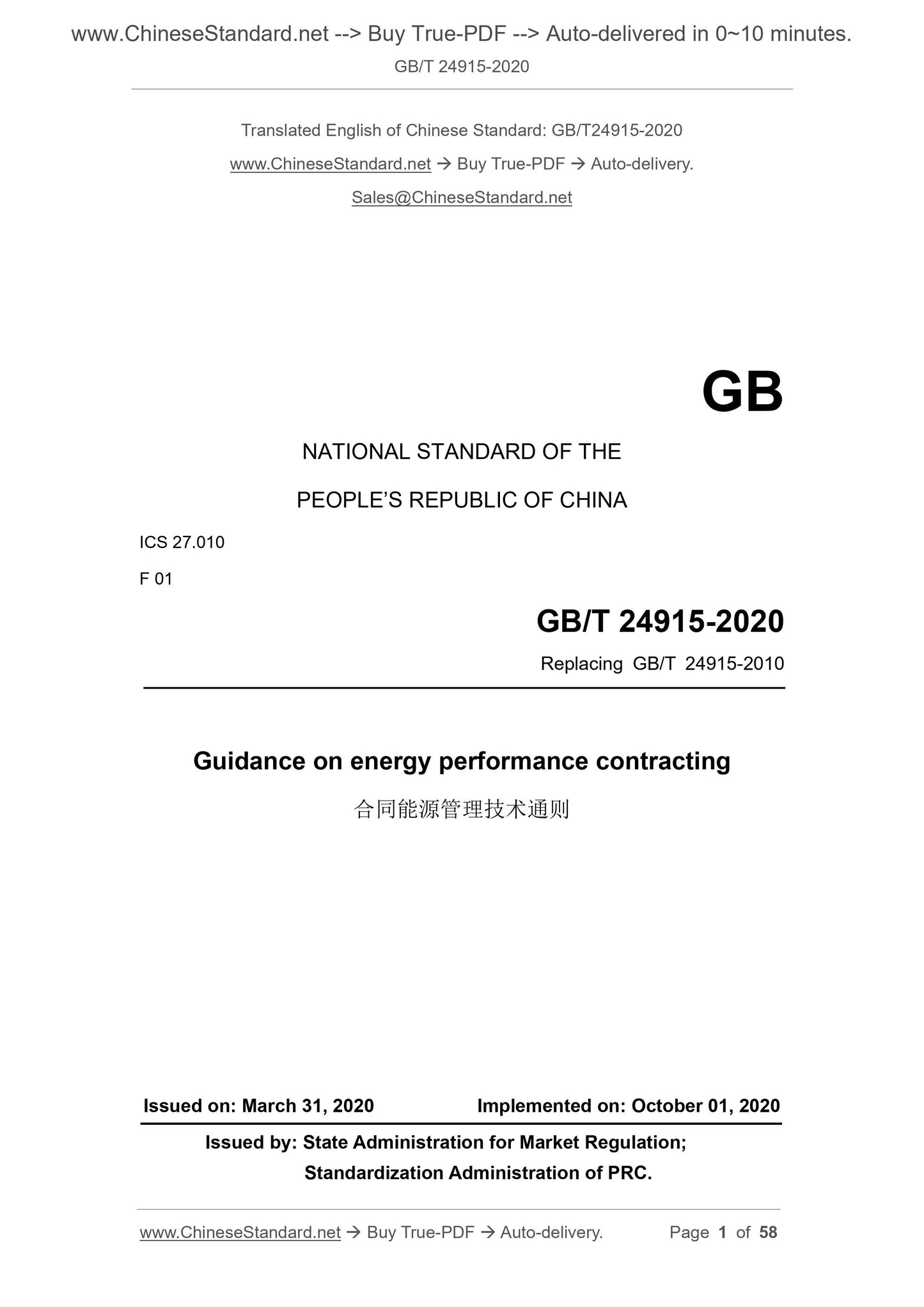

GB/T 24915-2020
GB
NATIONAL STANDARD OF THE
PEOPLE’S REPUBLIC OF CHINA
ICS 27.010
F 01
Replacing GB/T 24915-2010
Guidance on energy performance contracting
ISSUED ON: MARCH 31, 2020
IMPLEMENTED ON: OCTOBER 01, 2020
Issued by: State Administration for Market Regulation;
Standardization Administration of PRC.

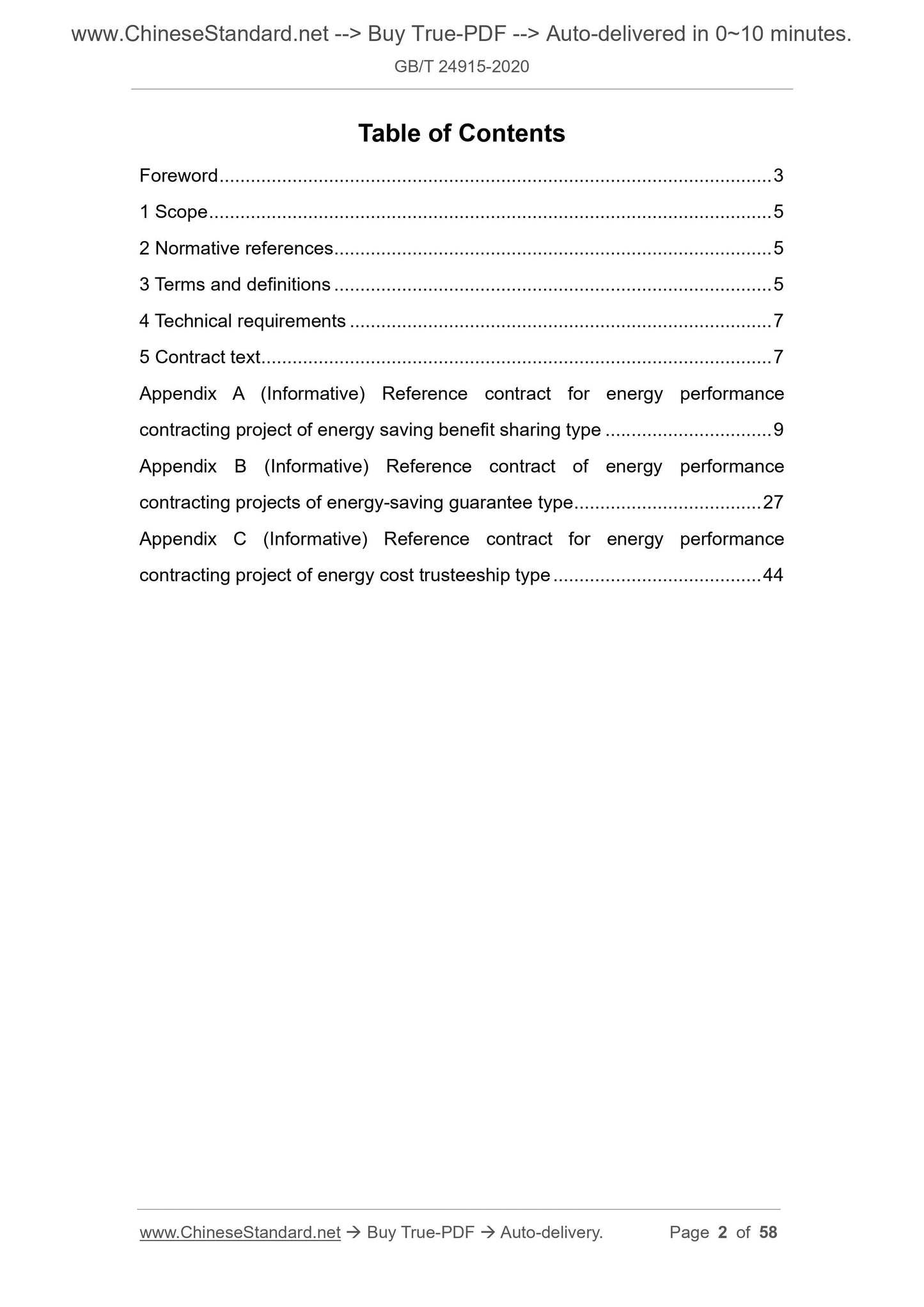

Table of Contents
Foreword ... 3
1 Scope ... 5
2 Normative references ... 5
3 Terms and definitions ... 5
4 Technical requirements ... 7
5 Contract text ... 7
Appendix A (Informative) Reference contract for energy performance
contracting project of energy saving benefit sharing type ... 9
Appendix B (Informative) Reference contract of energy performance
contracting projects of energy-saving guarantee type ... 27
Appendix C (Informative) Reference contract for energy performance
contracting project of energy cost trusteeship type ... 44

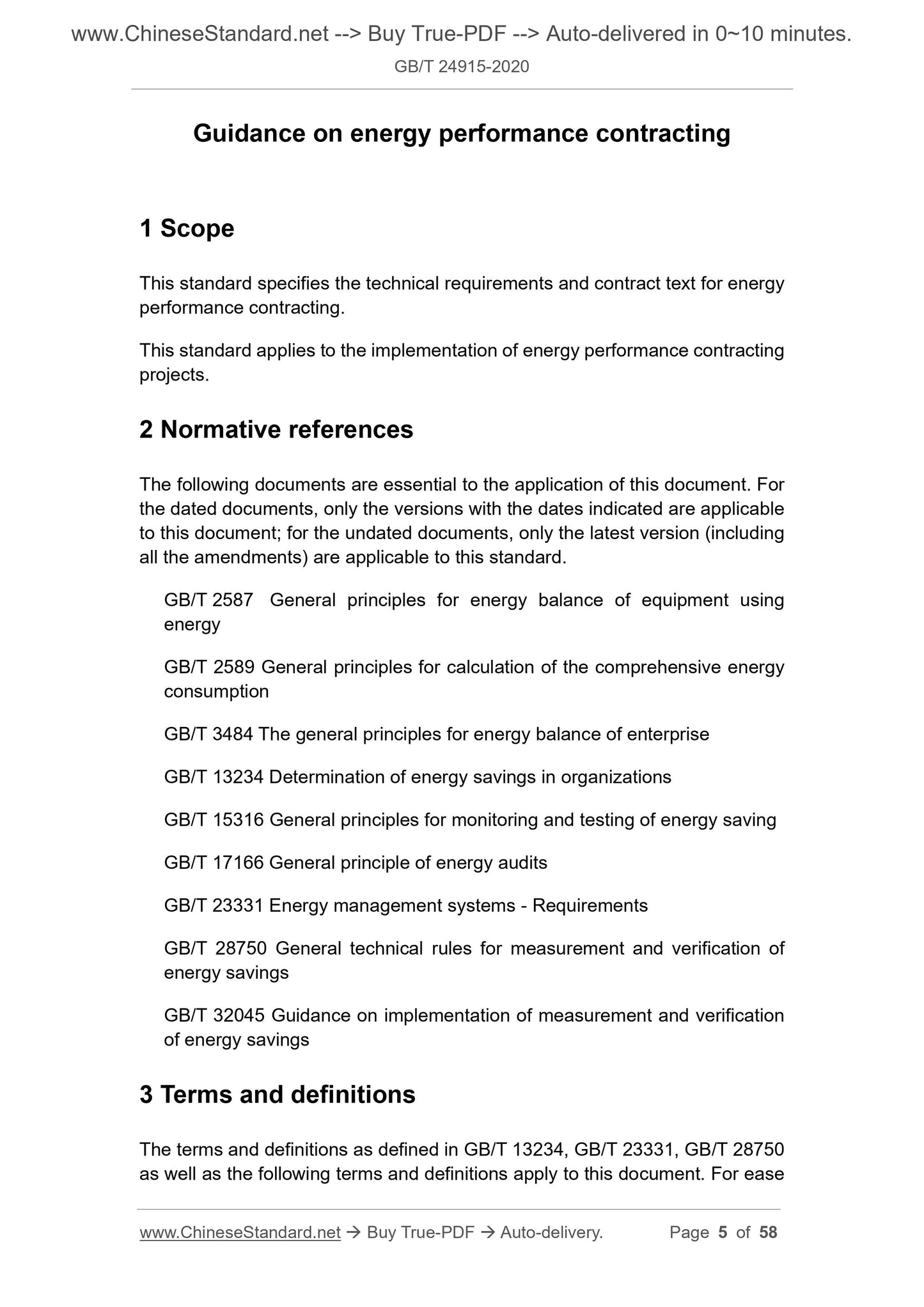

Guidance on energy performance contracting
1 Scope
This standard specifies the technical requirements and contract text for energy
performance contracting.
This standard applies to the implementation of energy performance contracting
projects.
2 Normative references
The following documents are essential to the application of this document. For
the dated documents, only the versions with the dates indicated are applicable
to this document; for the undated documents, only the latest version (including
all the amendments) are applicable to this standard.
GB/T 2587 General principles for energy balance of equipment using
energy
GB/T 2589 General principles for calculation of the comprehensive energy
consumption
GB/T 3484 The general principles for energy balance of enterprise
GB/T 13234 Determination of energy savings in organizations
GB/T 15316 General principles for monitoring and testing of energy saving
GB/T 17166 General principle of energy audits
GB/T 23331 Energy management systems - Requirements
GB/T 28750 General technical rules for measurement and verification of
energy savings
GB/T 32045 Guidance on implementation of measurement and verification
of energy savings
3 Terms and definitions
The terms and definitions as defined in GB/T 13234, GB/T 23331, GB/T 28750
as well as the following terms and definitions apply to this document. For ease
[GB/T 23331-2012, definition 3.6]
3.5
Energy savings
The amount of energy consumption/energy consumption reduction under
the conditions of meeting the same demand or achieving the same purpose.
[GB/T 13234-2018, definition 3.1]

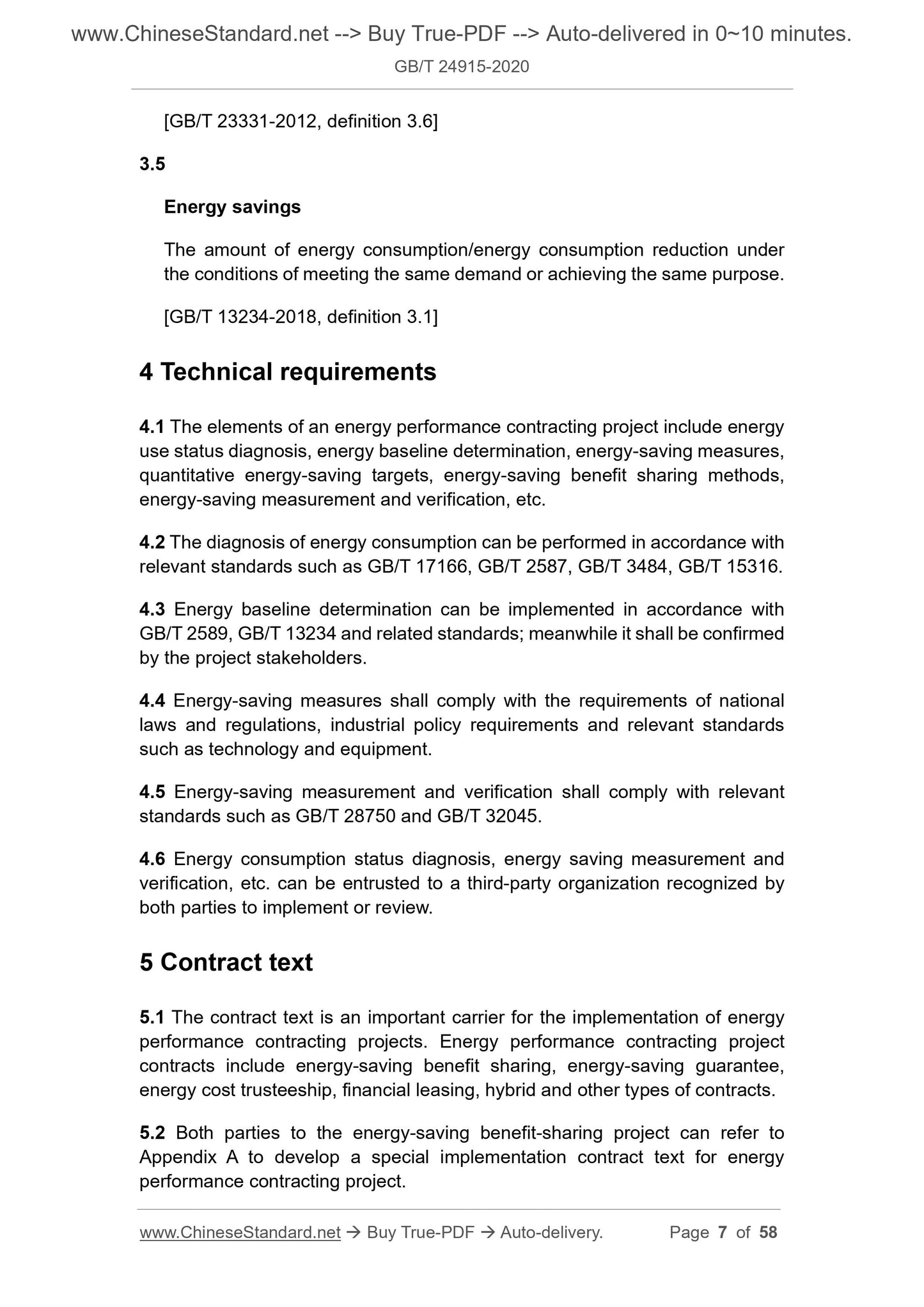

4 Technical requirements
4.1 The elements of an energy performance contracting project include energy
use status diagnosis, energy baseline determination, energy-saving measures,
quantitative energy-saving targets, energy-saving benefit sharing methods,
energy-saving measurement and verification, etc.
4.2 The diagnosis of energy consumption can be performed in accordance with
relevant standards such as GB/T 17166, GB/T 2587, GB/T 3484, GB/T 15316.
4.3 Energy baseline determination can be implemented in accordance with
GB/T 2589, GB/T 13234 and related standards; meanwhile it shall be confirmed
by the project stakeholders.
4.4 Energy-saving measures shall comply with the requirements of national
laws and regulations, industrial policy requirements and relevant standards
such as technology and equipment.
4.5 Energy-saving measurement and verification shall comply with relevant
standards such as GB/T 28750 and GB/T 32045.
4.6 Energy consumption status diagnosis, energy saving measurement and
verification, etc. can be entrusted to a third-party organization recognized by
both parties to implement or review.
5 Contract text
5.1 The contract text is an important carrier for the implementation of energy
performance contracting projects. Energy performance contracting project
contracts include energy-saving benefit sharing, energy-saving guarantee,
energy cost trusteeship, financial leasing, hybrid and other types of contracts.
5.2 Both parties to the energy-saving benefit-sharing project can refer to
Appendix A to develop a special implementation contract text for energy
performance contracting project.

The energy-saving service mechanism that the energy services company and
the energy user agree on the energy-saving goal of the energy-saving project
in the form of a contract, the energy services company provides the energy user
with necessary services to achieve the energy-saving goal, the energy user
pays for the investment and reasonable profit to the energy services company
in terms of energy-saving benefit, energy-saving service fee, or energy
trusteeship fee.
1.2 Energy saving
The amount of energy consumption/energy consumption reduction under the
conditions of meeting the same demand or achieving the same purpose.
1.3 Energy performance
Measurable results related to energy efficiency, energy use, energy
consumption.
1.4 Energy performance parameters
A value or measure that can quantify energy performance.
(Note: Energy performance parameters can be represented by simple
quantities, ratios or more complex models.)
1.5 Energy baseline
A quantitative reference basis for comparing energy performance.
(Note: Under certain circumstances, energy costs can also be used as an
energy baseline.)
1.6 Base period
The time period before the implementation of energy performance improvement
measures used to compare and determine energy savings.
1.7 Baseline energy costs
The energy cost spent by the energy user in the base period.
1.8 Energy saving service fee
Through the implementation of energy performance contracting projects, the
corresponding energy-saving amount will be generated. The energy user will
reduce energy expenditure and increase revenue; will pay the reduced energy
cost and part of the increased revenue to the energy services company as a
reward.

2.3 Project location: _______.
Article 3 The equipment system to be renovated and its energy
consumption status
3.1 The equipment intended for energy-saving renovation includes _________.
3.2 For the detailed energy consumption status before the energy-saving
renovation, please refer to Annex 1 "Project technical plan".
Article 4 Energy audit and energy baseline
4.1 Energy audit can choose any of the following methods:
(1) Completed by Party-B.
(2) Completed by Party-B and Party-A jointly.
(3) Completed by a third-party audit institution recognized by both parties.
The energy audit period is ___ days. The starting date is: ___ year, ___ month,
___ day; the completion date is: ___ year, ___month, ___ day.
4.2 Conduct energy audit in accordance with GB/T 17166 "General technical
principles of energy audit".
4.3 The cost of the energy audit shall be borne by ______.
4.4 Energy usage records and data required for energy audit:
(1) Energy consumption account for the past ___ years;
(2) Real-time test data of the energy efficiency of the equipment to be
renovated;
(3) The description of all equipment to be renovated as related to energy use;
(4) The energy consumption status and possible changes of the relevant
energy-consuming equipment during the validity period of the contract;
(5) Current energy management regulations, methods, etc.;
(6) Other information deemed necessary by the energy audit agency.
The above-mentioned information and data shall be provided by Party-A
comprehensively and truthfully, meanwhile it shall be listed item by item in the
energy audit report.
4.5 The data and content of the energy audit report shall be confirmed by Party-
limited to: _____________.
6.4 Party-B’s technical services include: ____________.

Article 7 Equipment procurement, installation and commissioning
7.1 Equipment purchase: Party-B is responsible for it.
7.2 Equipment arrival time: Within ___ working day after this contract takes
effect. Delivery and installation location: Same as project location.
7.3 After the equipment is delivered to the site, Party-A shall check the quantity,
specifications, product name and packaging of the equipment and confirm
whether it is complete, etc. Meanwhile it shall be responsible for keeping it
properly until the engineering and technical personnel of Party-B enter the site
for installation. If the equipment is inconsistent with the provisions of this
contract, Party-A shall notice the Party-B within three days. Party-A shall not
open the package. If the equipment is damaged or lost due to improper storage
by Party-A, Party-A shall be liable to Party-B for compensation based on the
actual value of the equipment loss.
7.4 Party-B is responsible for equipment installation, commissioning and
required expenses.
7.5 Party-A shall provide Party-B with facilities such as installation site,
construction conditions and equipment commissioning conditions; designate a
project leader to cooperate with Party-B to ensure smooth installation and
commissioning.
7.6 Installation and commissioning period: The installation and commissioning
shall be completed within ___ days after the equipment is delivered to the site
and confirmed by Party-A; it shall be completed by the ___month ___ day at
the latest.
7.7 During the debugging and testing of the equipment, if the equipment fails to
meet the requirements for use due to other equipment of Party-A, Party-A shall
work with the commissioning personnel of Party-B to adjust the relevant
equipment of Party-A.
7.8 Party-B guarantees the reliability and safety of the equipment installation
and will not cause damage to Party-A's production system after operation. If
Party-A's production system is damaged, Party-B shall be responsible for
repairs and bear the cost.
7.9 Party-B can install, debug and construct by itself or entrust a third party with
corresponding qualifications.

management, Party-A shall bear the maintenance costs.
10.3 Party-B shall send someone to the site for maintenance within ___ hours
after receiving the notification of the failure from Party-A.
10.4 After the end of the warranty period, Party-B provides paid maintenance
services and preferential supply of equipment parts.
(Note: If the equipment is not manufactured by an energy services company, or
other complete equipment, after-sales service can be transferred to the
equipment supplier or equipment manufacturer. Service costs are included in
the equipment payment. A tripartite agreement is signed to determine the after-
sales service responsibility.)
Article 11 Project operation management and training
11.1 Party-A is responsible for the operation and management of the project.
The operation and management shall comply with the equipment and related
operating procedures.
11.2 Party-A shall record the parameters and energy consumption of the
equipment and keep relevant data for verification (it can also introduce a third
party to monitor energy consumption and make real-time testing records).
11.3 Party-B is responsible for the technical training of equipment operation and
maintenance for Party-A’s operation and management personnel. The number
of trainees and training content are determined according to actual needs.
Party-A shall assign qualified personnel to participate in the training.
11.4 After the training is completed, both parties shall confirm the situation of
the trainees, training content, training results in writing for verification.
11.5 The operation and management costs of the project shall be borne by
Party-A (operating party).
Article 12 Equipment ownership agreement
12.1 After the project is delivered to Party-A for operation and management, the
possession and use rights of the equipment are handed over to Party-A.
12.2 Party-B has limited ownership of the equipment, that is, the right to dispose
of the equipment belongs to Party-B before Party-A has paid off all the money
to the Party-B in accordance with this contract. In case of collection, relocation,
the Party-A’s bankruptcy, or other cases where the equipment must be disposed
of, unless otherwise agreed by the Party-B, the Party-A shall not make any
decision to dispose of equipment; the disposition proceeds belong to Party-B.

14.1 Energy-saving benefit is the converted market value of the energy-saving
amount produced in the current period (referring to the life of the energy-saving
plan design project) after the project is implemented. Energy-saving benefits
are reflected in Party-A’s reduced energy expenditures and Party-B’s energy-
saving project revenues.
14.2 The energy-saving amount determined in accordance with Article 13 of this
contract, combined with the supply price of the energy supply organization
where the project is located to Party-A, serve as the calculation basis for the
energy-saving benefits as shared between the Party-A and Party-B.
14.3 Calculate the energy-saving benefits of the project in the current period in
accordance with Annex III of this contract. Then calculate the energy-saving
benefits that Party-B shall obtain according to the proportion agreed in this
contract.
14.4 Energy-saving benefit sharing period: Totally ___ years, calculated from
___ year, ___ month, ___ day (from the date of signing the project acceptance
report or the day when the project is handed over to Party-A) to ___ year, ___
month, ___ day.
14.5 The proportion of energy-saving benefits shared by Party-A and Party-B:
during the energy-saving benefit sharing period, the total energy expenditure
reduced is the energy-saving benefit, which is ___ 10000 yuan, wherein the
Party-A enjoys ___%, that is, ___ 10000 yuan; the Party-B enjoys ___%, that
is, ___ 10000 yuan.
14.6 If the energy-saving rate after acceptance exceeds or is lower than the
designed average value by more than 10%, the energy-saving benefit sharing
data determined in this contract shall be adjusted according to the actual
energy-saving rate; meanwhile the adjustment results shall be confirmed in the
acceptance report.
14.7 Af...
Delivery: 9 seconds. Download (& Email) true-PDF + Invoice.
Get Quotation: Click GB/T 24915-2020 (Self-service in 1-minute)
Historical versions (Master-website): GB/T 24915-2020
Preview True-PDF (Reload/Scroll-down if blank)
GB/T 24915-2020
GB
NATIONAL STANDARD OF THE
PEOPLE’S REPUBLIC OF CHINA
ICS 27.010
F 01
Replacing GB/T 24915-2010
Guidance on energy performance contracting
ISSUED ON: MARCH 31, 2020
IMPLEMENTED ON: OCTOBER 01, 2020
Issued by: State Administration for Market Regulation;
Standardization Administration of PRC.
Table of Contents
Foreword ... 3
1 Scope ... 5
2 Normative references ... 5
3 Terms and definitions ... 5
4 Technical requirements ... 7
5 Contract text ... 7
Appendix A (Informative) Reference contract for energy performance
contracting project of energy saving benefit sharing type ... 9
Appendix B (Informative) Reference contract of energy performance
contracting projects of energy-saving guarantee type ... 27
Appendix C (Informative) Reference contract for energy performance
contracting project of energy cost trusteeship type ... 44
Guidance on energy performance contracting
1 Scope
This standard specifies the technical requirements and contract text for energy
performance contracting.
This standard applies to the implementation of energy performance contracting
projects.
2 Normative references
The following documents are essential to the application of this document. For
the dated documents, only the versions with the dates indicated are applicable
to this document; for the undated documents, only the latest version (including
all the amendments) are applicable to this standard.
GB/T 2587 General principles for energy balance of equipment using
energy
GB/T 2589 General principles for calculation of the comprehensive energy
consumption
GB/T 3484 The general principles for energy balance of enterprise
GB/T 13234 Determination of energy savings in organizations
GB/T 15316 General principles for monitoring and testing of energy saving
GB/T 17166 General principle of energy audits
GB/T 23331 Energy management systems - Requirements
GB/T 28750 General technical rules for measurement and verification of
energy savings
GB/T 32045 Guidance on implementation of measurement and verification
of energy savings
3 Terms and definitions
The terms and definitions as defined in GB/T 13234, GB/T 23331, GB/T 28750
as well as the following terms and definitions apply to this document. For ease
[GB/T 23331-2012, definition 3.6]
3.5
Energy savings
The amount of energy consumption/energy consumption reduction under
the conditions of meeting the same demand or achieving the same purpose.
[GB/T 13234-2018, definition 3.1]
4 Technical requirements
4.1 The elements of an energy performance contracting project include energy
use status diagnosis, energy baseline determination, energy-saving measures,
quantitative energy-saving targets, energy-saving benefit sharing methods,
energy-saving measurement and verification, etc.
4.2 The diagnosis of energy consumption can be performed in accordance with
relevant standards such as GB/T 17166, GB/T 2587, GB/T 3484, GB/T 15316.
4.3 Energy baseline determination can be implemented in accordance with
GB/T 2589, GB/T 13234 and related standards; meanwhile it shall be confirmed
by the project stakeholders.
4.4 Energy-saving measures shall comply with the requirements of national
laws and regulations, industrial policy requirements and relevant standards
such as technology and equipment.
4.5 Energy-saving measurement and verification shall comply with relevant
standards such as GB/T 28750 and GB/T 32045.
4.6 Energy consumption status diagnosis, energy saving measurement and
verification, etc. can be entrusted to a third-party organization recognized by
both parties to implement or review.
5 Contract text
5.1 The contract text is an important carrier for the implementation of energy
performance contracting projects. Energy performance contracting project
contracts include energy-saving benefit sharing, energy-saving guarantee,
energy cost trusteeship, financial leasing, hybrid and other types of contracts.
5.2 Both parties to the energy-saving benefit-sharing project can refer to
Appendix A to develop a special implementation contract text for energy
performance contracting project.
The energy-saving service mechanism that the energy services company and
the energy user agree on the energy-saving goal of the energy-saving project
in the form of a contract, the energy services company provides the energy user
with necessary services to achieve the energy-saving goal, the energy user
pays for the investment and reasonable profit to the energy services company
in terms of energy-saving benefit, energy-saving service fee, or energy
trusteeship fee.
1.2 Energy saving
The amount of energy consumption/energy consumption reduction under the
conditions of meeting the same demand or achieving the same purpose.
1.3 Energy performance
Measurable results related to energy efficiency, energy use, energy
consumption.
1.4 Energy performance parameters
A value or measure that can quantify energy performance.
(Note: Energy performance parameters can be represented by simple
quantities, ratios or more complex models.)
1.5 Energy baseline
A quantitative reference basis for comparing energy performance.
(Note: Under certain circumstances, energy costs can also be used as an
energy baseline.)
1.6 Base period
The time period before the implementation of energy performance improvement
measures used to compare and determine energy savings.
1.7 Baseline energy costs
The energy cost spent by the energy user in the base period.
1.8 Energy saving service fee
Through the implementation of energy performance contracting projects, the
corresponding energy-saving amount will be generated. The energy user will
reduce energy expenditure and increase revenue; will pay the reduced energy
cost and part of the increased revenue to the energy services company as a
reward.
2.3 Project location: _______.
Article 3 The equipment system to be renovated and its energy
consumption status
3.1 The equipment intended for energy-saving renovation includes _________.
3.2 For the detailed energy consumption status before the energy-saving
renovation, please refer to Annex 1 "Project technical plan".
Article 4 Energy audit and energy baseline
4.1 Energy audit can choose any of the following methods:
(1) Completed by Party-B.
(2) Completed by Party-B and Party-A jointly.
(3) Completed by a third-party audit institution recognized by both parties.
The energy audit period is ___ days. The starting date is: ___ year, ___ month,
___ day; the completion date is: ___ year, ___month, ___ day.
4.2 Conduct energy audit in accordance with GB/T 17166 "General technical
principles of energy audit".
4.3 The cost of the energy audit shall be borne by ______.
4.4 Energy usage records and data required for energy audit:
(1) Energy consumption account for the past ___ years;
(2) Real-time test data of the energy efficiency of the equipment to be
renovated;
(3) The description of all equipment to be renovated as related to energy use;
(4) The energy consumption status and possible changes of the relevant
energy-consuming equipment during the validity period of the contract;
(5) Current energy management regulations, methods, etc.;
(6) Other information deemed necessary by the energy audit agency.
The above-mentioned information and data shall be provided by Party-A
comprehensively and truthfully, meanwhile it shall be listed item by item in the
energy audit report.
4.5 The data and content of the energy audit report shall be confirmed by Party-
limited to: _____________.
6.4 Party-B’s technical services include: ____________.
Article 7 Equipment procurement, installation and commissioning
7.1 Equipment purchase: Party-B is responsible for it.
7.2 Equipment arrival time: Within ___ working day after this contract takes
effect. Delivery and installation location: Same as project location.
7.3 After the equipment is delivered to the site, Party-A shall check the quantity,
specifications, product name and packaging of the equipment and confirm
whether it is complete, etc. Meanwhile it shall be responsible for keeping it
properly until the engineering and technical personnel of Party-B enter the site
for installation. If the equipment is inconsistent with the provisions of this
contract, Party-A shall notice the Party-B within three days. Party-A shall not
open the package. If the equipment is damaged or lost due to improper storage
by Party-A, Party-A shall be liable to Party-B for compensation based on the
actual value of the equipment loss.
7.4 Party-B is responsible for equipment installation, commissioning and
required expenses.
7.5 Party-A shall provide Party-B with facilities such as installation site,
construction conditions and equipment commissioning conditions; designate a
project leader to cooperate with Party-B to ensure smooth installation and
commissioning.
7.6 Installation and commissioning period: The installation and commissioning
shall be completed within ___ days after the equipment is delivered to the site
and confirmed by Party-A; it shall be completed by the ___month ___ day at
the latest.
7.7 During the debugging and testing of the equipment, if the equipment fails to
meet the requirements for use due to other equipment of Party-A, Party-A shall
work with the commissioning personnel of Party-B to adjust the relevant
equipment of Party-A.
7.8 Party-B guarantees the reliability and safety of the equipment installation
and will not cause damage to Party-A's production system after operation. If
Party-A's production system is damaged, Party-B shall be responsible for
repairs and bear the cost.
7.9 Party-B can install, debug and construct by itself or entrust a third party with
corresponding qualifications.
management, Party-A shall bear the maintenance costs.
10.3 Party-B shall send someone to the site for maintenance within ___ hours
after receiving the notification of the failure from Party-A.
10.4 After the end of the warranty period, Party-B provides paid maintenance
services and preferential supply of equipment parts.
(Note: If the equipment is not manufactured by an energy services company, or
other complete equipment, after-sales service can be transferred to the
equipment supplier or equipment manufacturer. Service costs are included in
the equipment payment. A tripartite agreement is signed to determine the after-
sales service responsibility.)
Article 11 Project operation management and training
11.1 Party-A is responsible for the operation and management of the project.
The operation and management shall comply with the equipment and related
operating procedures.
11.2 Party-A shall record the parameters and energy consumption of the
equipment and keep relevant data for verification (it can also introduce a third
party to monitor energy consumption and make real-time testing records).
11.3 Party-B is responsible for the technical training of equipment operation and
maintenance for Party-A’s operation and management personnel. The number
of trainees and training content are determined according to actual needs.
Party-A shall assign qualified personnel to participate in the training.
11.4 After the training is completed, both parties shall confirm the situation of
the trainees, training content, training results in writing for verification.
11.5 The operation and management costs of the project shall be borne by
Party-A (operating party).
Article 12 Equipment ownership agreement
12.1 After the project is delivered to Party-A for operation and management, the
possession and use rights of the equipment are handed over to Party-A.
12.2 Party-B has limited ownership of the equipment, that is, the right to dispose
of the equipment belongs to Party-B before Party-A has paid off all the money
to the Party-B in accordance with this contract. In case of collection, relocation,
the Party-A’s bankruptcy, or other cases where the equipment must be disposed
of, unless otherwise agreed by the Party-B, the Party-A shall not make any
decision to dispose of equipment; the disposition proceeds belong to Party-B.
14.1 Energy-saving benefit is the converted market value of the energy-saving
amount produced in the current period (referring to the life of the energy-saving
plan design project) after the project is implemented. Energy-saving benefits
are reflected in Party-A’s reduced energy expenditures and Party-B’s energy-
saving project revenues.
14.2 The energy-saving amount determined in accordance with Article 13 of this
contract, combined with the supply price of the energy supply organization
where the project is located to Party-A, serve as the calculation basis for the
energy-saving benefits as shared between the Party-A and Party-B.
14.3 Calculate the energy-saving benefits of the project in the current period in
accordance with Annex III of this contract. Then calculate the energy-saving
benefits that Party-B shall obtain according to the proportion agreed in this
contract.
14.4 Energy-saving benefit sharing period: Totally ___ years, calculated from
___ year, ___ month, ___ day (from the date of signing the project acceptance
report or the day when the project is handed over to Party-A) to ___ year, ___
month, ___ day.
14.5 The proportion of energy-saving benefits shared by Party-A and Party-B:
during the energy-saving benefit sharing period, the total energy expenditure
reduced is the energy-saving benefit, which is ___ 10000 yuan, wherein the
Party-A enjoys ___%, that is, ___ 10000 yuan; the Party-B enjoys ___%, that
is, ___ 10000 yuan.
14.6 If the energy-saving rate after acceptance exceeds or is lower than the
designed average value by more than 10%, the energy-saving benefit sharing
data determined in this contract shall be adjusted according to the actual
energy-saving rate; meanwhile the adjustment results shall be confirmed in the
acceptance report.
14.7 Af...
Share
